Technical Manual for Drilling Works for Technical Support Plan for the Drillers in DDCA (2013) - page 6



  Index      Manuals     Technical Manual for Drilling Works for Technical Support Plan for the Drillers in DDCA (2013)



Search            copyright infringement











Content      ..     4      5      6      7     ..







Technical Manual for Drilling Works for Technical Support Plan for the Drillers in DDCA (2013) - page 6





Guideline on Hiring of Drilling Equipment
7. ESTABLISHMENT OF THE HIRING BUSINESS UNIT
7.1 JOB DESCRIPTION
DDCA will establish the Hiring Business Unit under the Business Support Department in order to
manage daily operation of the hiring service. The Unit will be responsible for tasks mentioned
below;
To administer hiring process including appraisal and selection of the qualified hirers,
contract management, and customer care.
To keep and update information of particulars of clients.
To coordinate with other departments in the organization for arrangement of the technical
instructors and other required staff, maintenance of the hired equipment, and procurement of
consumables and other materials for the drilling equipment as may be necessary.
To prepare the budget for operation of the hiring service to be included in annual budget
proposals of DDCA.
To set/review and propose the tariff for approval by the management of DDCA.
To prepare monthly reports on operational and financial status of the service provision.
To coordinate with Marketing and Public Relations (PR) Section in preparation of PR
materials and communication with potential clients for business promotion.

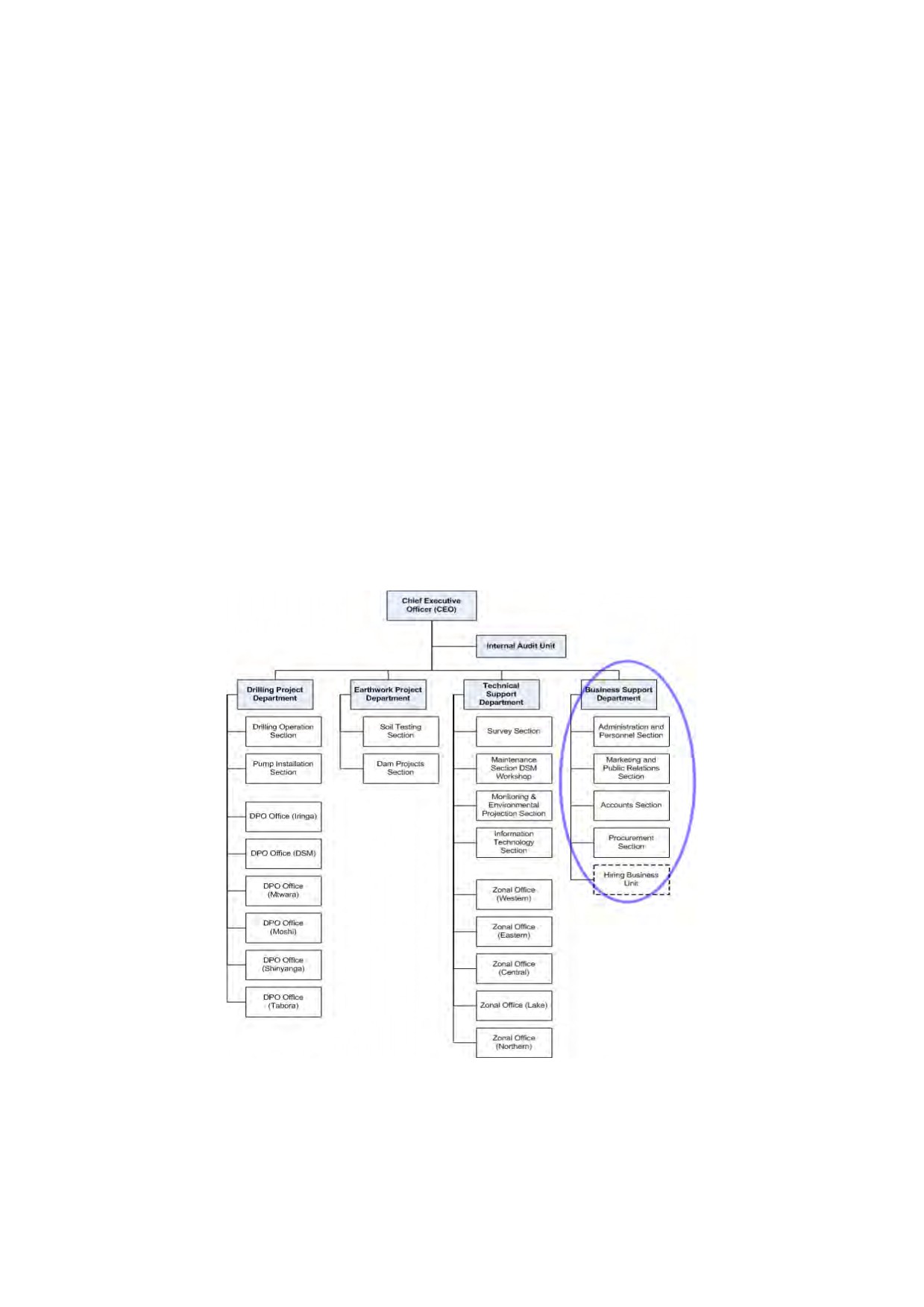

Figure 29 shows an organigram of DDCA which includes structure of the Business Support
Department with Hiring Business Unit.
Figure 29 Organizational Structure of DDCA with the Hiring Business Unit
The Unit will involve the legal officer(s) of DDCA in contract management for the hiring service
and seek advice from the Legal Unit of MoW when necessary. The Unit will also work closely
35
Guideline on Hiring of Drilling Equipment
with the Procurement Section of DDCA to purchase consumables and spare parts of drilling
equipment in time for its hiring.
In the long-term, DDCA will consider if it should transform the Unit to the Hirng Business
Department. Establishment of the Hiring Business Department needs approval from Presient’s
Office-Public Service Management (PO-PSM). DDCA will follow necessary procedures for
application for establishment of the new department through MoW when it resolves to do so.
7.2 PERSONNEL ARRANGEMENT PLAN
A full-time administration officer and an assistant staff are required in the Unit to be supervised by
the manager of the Business Support Department who will serve concurrently as the head of the
Unit. DDCA is planning to reallocate existing staff to fulfill the staffing plan for the Hiring
Business Unit instead of recruiting new personnel. The staffing plan will be reviewed from time
to time according to volume of works to be involved in the Unit staff.
8. PERFORMANCE MANAGEMENT
8.1 KEY PERFORMANCE INDICATORS
Applying the key performance indicators listed below, the Hiring Business Unit will monitor
process, output and outcomes of the equipment hiring service.
Table 17 Key Performance Indicators of the Equipment Hiring Service
Means
of
Frequency of
Purpose
Indicators
Verification
Monitoring
1-1.Drilling equipmemt is hired in
1-1.Records for
1-1.Daily
accordance with the procedures
hiring
1-2.Monthly
established.
1-2.Maintenance
1-2.All drilling equipment for hiring is
records of
1. Process
maintained in accordance with the
drilling
1-3.Monthly
Management
maintenance plan.
eqiupment for
1-3.Internal management accounting
hiring
document for hiring is reported
1-3.Reports on hiring
periodically to the management.
service
2-1. The number of operation days of a
2-1. Records for
2-1. Monthly
drilling rig for hiring reaches to 141
hiring
days per annum on average, the
break even line of the hiring
2-2. Monthly
business8, by 2016.
2-2. Records for
2-2. More than 80% of the registered
hiring
2.
water well drilling companies utilize
2-3. Each
Managemene
some forms of the technical support
hiring
t of Output of
services by 2016.
2-3. Feedback forms
conctract,
the Service
2-3. More than 80% of private drilling
from clients
Monthly
companies, which used the technical
support services provided by DDCA,
consider that the services they
received helped their business
activities.
3-1. The number of private companies
3-1. Records for
3-1. Annually
3. Management
which use the technical support
hiring, Water
of Outcomes
services of DDCA and participate in
Sector MIS
drilling works in WSDP increases by

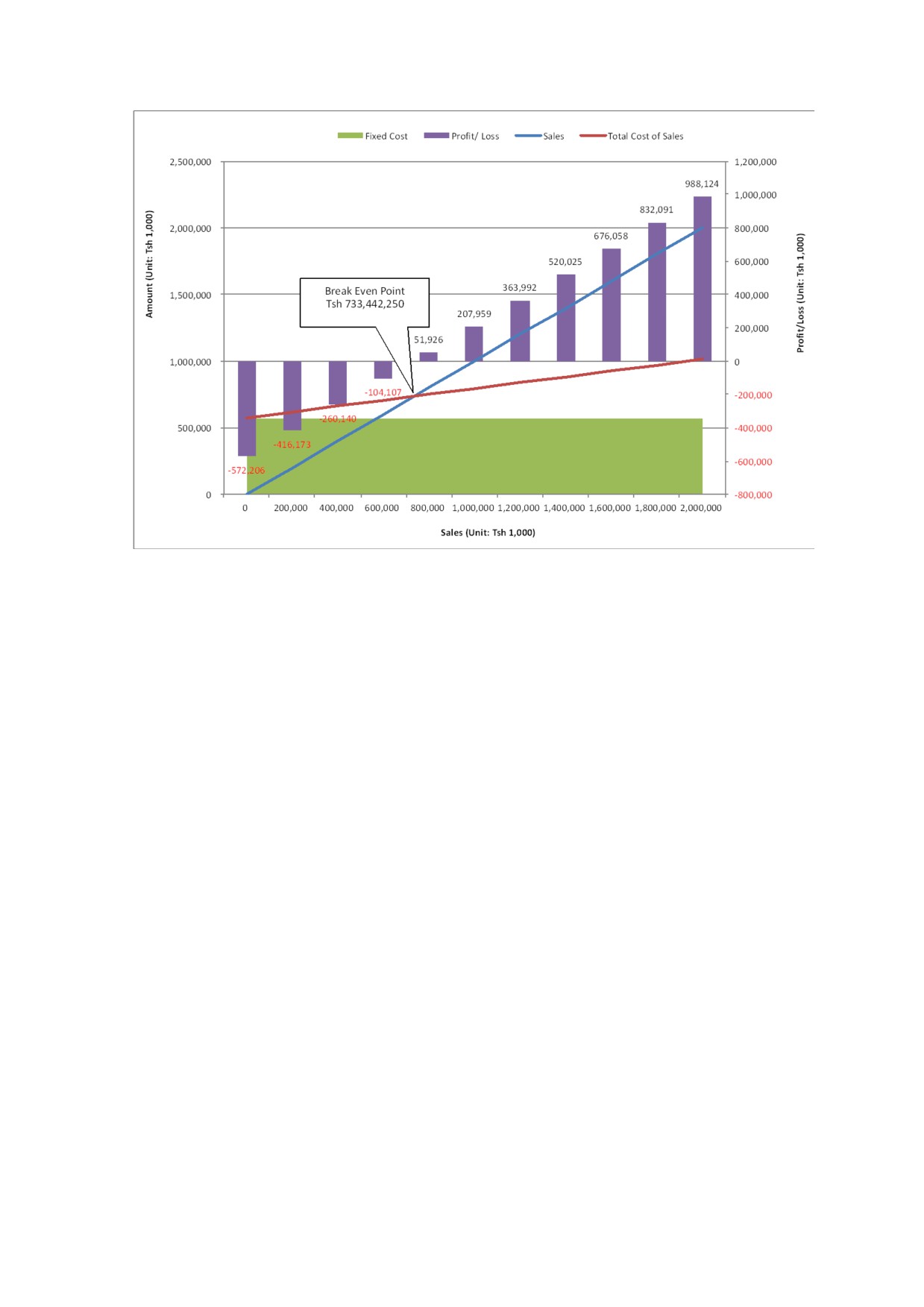

8 See Section 11.3 for an estimation of the break even line of the hiring business.
36
Guideline on Hiring of Drilling Equipment
Means
of Frequency of
Purpose
Indicators
Verification
Monitoring
122% by 2018, compared to the
status before official launch of the
3-2. Annually
service provision.
3-2. MoW Annual
3-2. The number of wells planned in
Water Sector
WSDP is constructed by 2015.
Status Report,
Water Sector
MIS
8.2 PERFORMANCE MONITORING REPORT
The Hiring Business Unit will prepare the following reports to be submitted to the management
team of DDCA and MAB;
Monthly report to be submitted not later than 10 days after the end of the month
Annual report to be submitted not later than 14 days after the end of the year
The above reporting procedures notwithstanding, DDCA shall report promptly to the Ministry on
any major event likely to affect efficient and effective utilization of the equipment.
9. OUTLINE OF THE BUSINESS FLOW

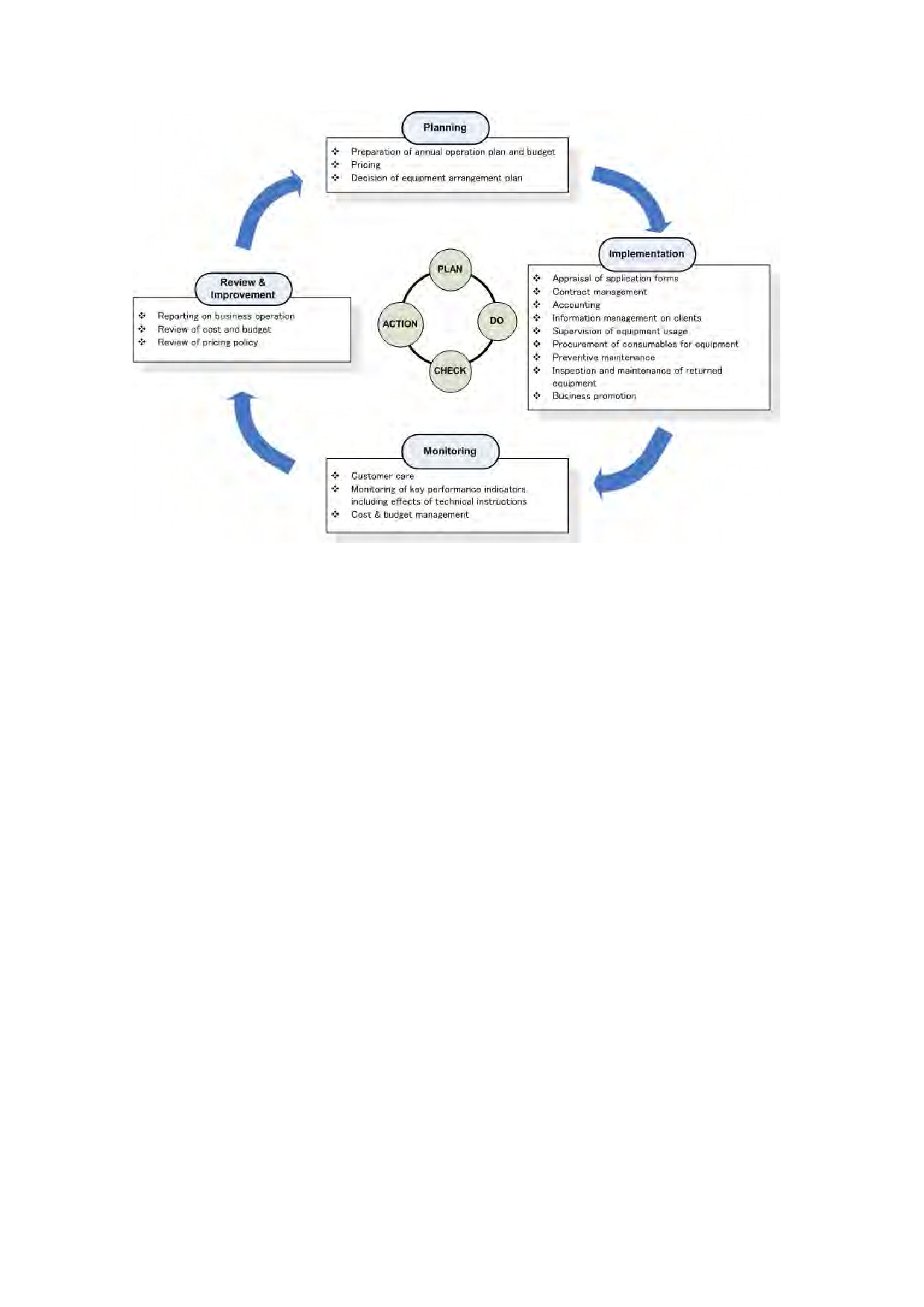

The hiring service will be operated in a Plan-Do-Check-Action (PDCA) cycle as described in
Figure 30. It starts from preparation of annual operation plan and budget of the hiring service
which is to be incorporated into the annual budget of DDCA. Rental fees as well as placement of
drilling rigs and other equipment for hiring at DDCA headquarters and/or its zonal office(s) should
be decided in the course of formulation of the annual operation plan and budget. The
implementation stage involves various administrative procedures in accordance with the process of
equipment hiring described in detail in Figure 31. Procedures instituted should be followed and
recorded properly to ensure accountability and transparency. The performance of the hiring
service will be monitoring from time to time to check;
if there are any gaps between what has been planned and implemented, and
if the expected output and outcomes are realized.
Actions should be taken to solve problems and improve the process management based on findings
from the monitoring. These improved solutions should also be reflected in the planning stage of
the subsequent cycle.
37
Guideline on Hiring of Drilling Equipment
Figure 30 Business Cycle of the Hiring Service
38
Guideline on Hiring of Drilling Equipment

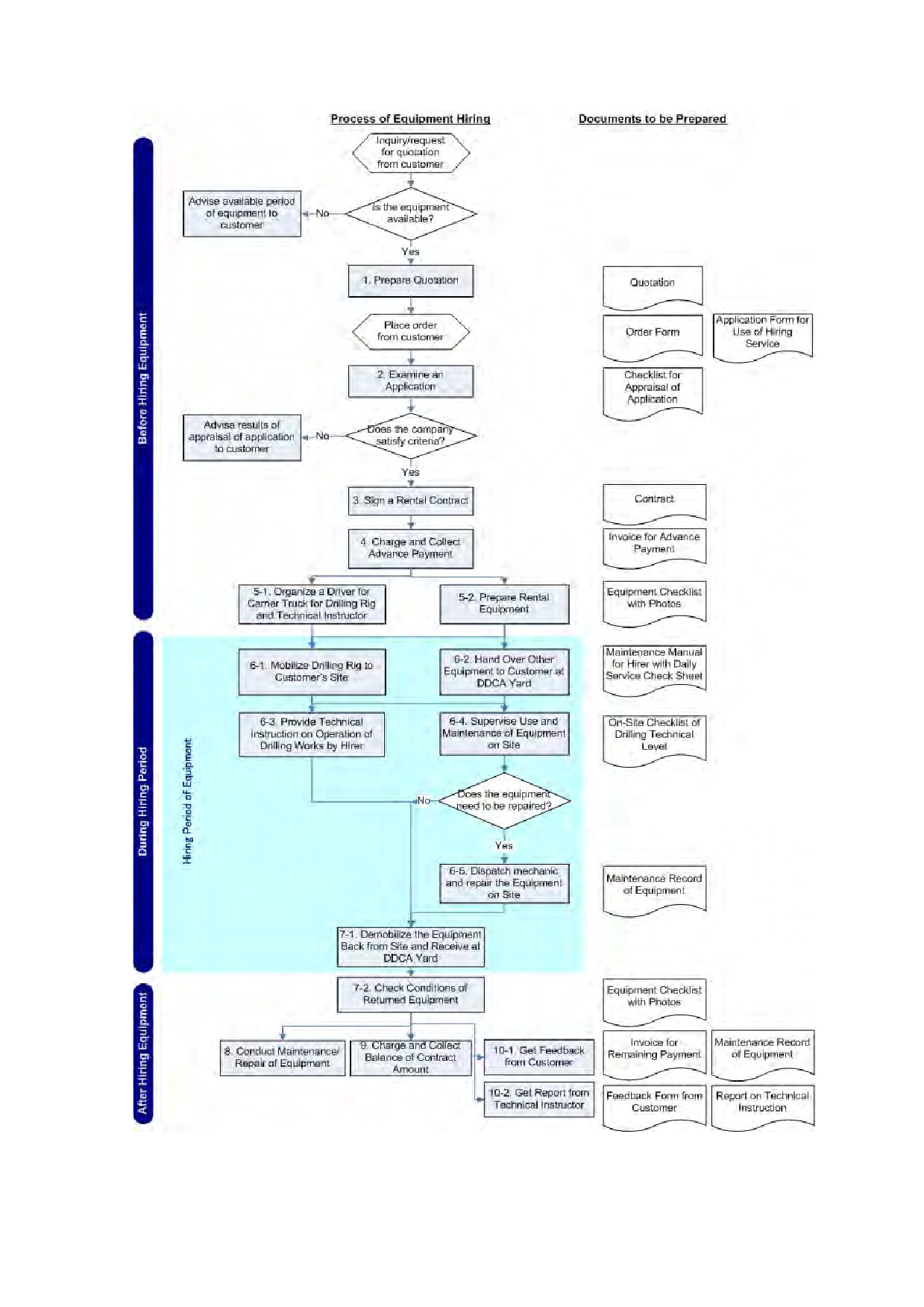

Figure 31 Process of Equipment Hiring
39
Guideline on Hiring of Drilling Equipment
10. BUSINESS PROMOTION
DDCA will promote the launch of technical support services including the equipment hiring to
potential clients. While the priority target is those which are classified into Group A and Group B
according to the results of the baseline survey, identification of new potential clients needs to be
conducted simultaneously. As mentioned in Section 3.3.3, there are 10 companies which were not
interviewed in the baseline survey although it was confirmed that these were also operating drilling
works. These companies should also be included in the target of the business promotion.
Means of the business promotion to be employed include mailing brochures explaining the service
contents to identified companies, introducing it to participants in regular and/or extraordinary
meetings of Drilling Association of Tanzania (DAT) and CRB, and publicize on newsletters to be
issued by CRB for its members.
11. FINANCE
11.1 BUDGET PREPARATION
The Hiring Business Unit is responsible to prepare budget for operation of the hiring service to be
incorporated into the annual budget of DDCA. For the budget prepration, reference should be
made to accounting manuals of DDCA.
(1) Expenditure

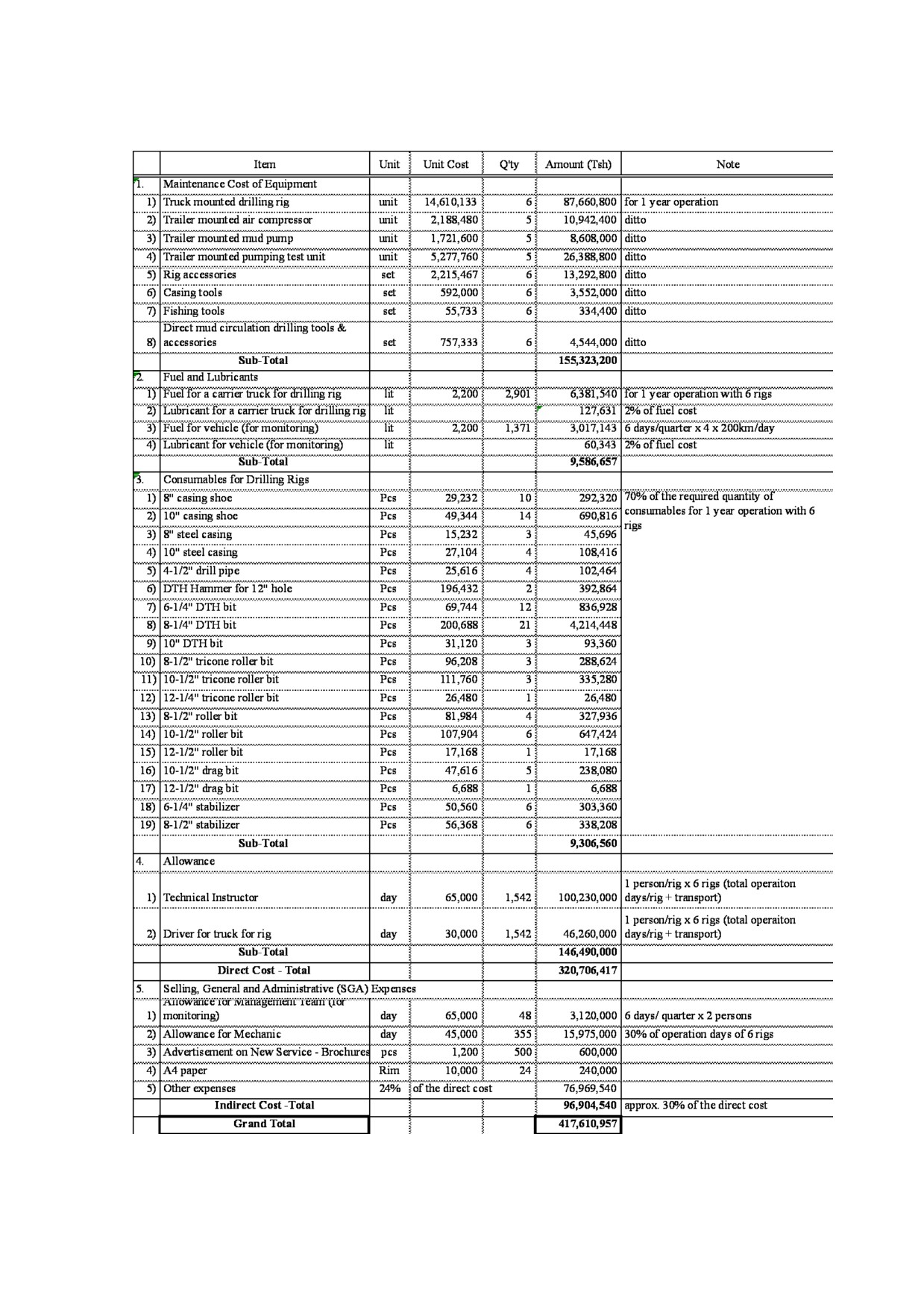

Table 18 in the next page shows an estimated annual expenditure of the hiring service for the case
that depreciation cost of the hiring equipment is considered. Approximately Tsh 912 million will
be required for annual operation of the service. Cost items considered in the estimation can be
categorized into the direct cost and indirect cost. The direct cost consists of 1) maintenance cost
of equipment, 2) fuel and lubricants, 3) consumables for drilling rigs, 4) allowance for staff to be
attached to the drilling rigs, and 5) depreciation of the equipment. The indirect cost, i.e. selling,
general and administrative expenses, include 1) allowance for the management team for monitoring,
2) allowance for mechanics for repair works of the equipment on site, 3) advertisement cost, 4)
stationery, and 5) other expenses such as staff salaries, utilities, office rent, and cost for staff
training. For comparison purpose, the estimated annual expenditure without depreciation cost is
indicated in Table 19. Basis of the estimation is explained below;
1) Maintenance Cost of Equipment
3.5% of the equipment price is considered as the annual maintenance cost for drilling rigs, air
compressors, mud pumps, and pumping test units. The percentage is based on historic costs for
maintenance of existing drilling rigs by DDCA.
As mentioned in Section 4.2, rig accessories, casing tools, and direct mud circulation drilling
tools and accessories contain i) items which are permanently provided with the drilling rigs and
ii) consumables which use is optional for the hirer. Maintenance costs are considered for those
which are equipped with drilling rigs permanently.
3.5% of the price of each item is applied as
the maintenance cost for these accessories and tools. Remaining parts are considered as
consumables. Also, all items in the category of steel working casing are regarded as
consumables, hence no maintenance cost included in the budget.
40
Guideline on Hiring of Drilling Equipment
Table 19 Expenditure Budget for Annual Operation of the Hiring Service (without
Depreciation Cost)
42
Guideline on Hiring of Drilling Equipment
2) Fuel and Lubricants
Costs for fuel and lubricants are considered for i) carrier trucks for drilling rigs for those
transportation between DDCA’s yard and client’s site as well as from one drilling site to the other
and ii) vehicles for monitoring visits by the management team.
Fuel costs for operation of the rig plant and other equipment are not included in the budget as
hirers are responsible to put in fuel on the hired equipment as they use.
3) Consumables for Drilling Rigs
Items included as consumables are bits, DTH hammers, stabilizers, casing shoes, steel work
casing, and drill pipes. Hirers can decide if they use their own stocks of these items for drilling
works or they buy necessary tools and accessories from DDCA. The cost of consumables
considered here is, therefore, to have some stocks of these items to be sold to the hirers when
necessary. As there would be some cases that the hirers use these items which they keep or
procure new ones from other suppliers, 70% of the required quantity of consumables for
one-year operation of six drilling rigs is included in the budget.
4) Allowance
One technical instructor and driver for carrier truck for rig plant will be attached to each drilling
rig. Their field allowances are considered as a part of the direct cost of the hiring service.
Number of days considered for one person is a total of operation days and time to be taken for
transportation of a drilling rig.
5) Depreciation of Equipment
The depreciation of the equipment is regarded as a part of the direct cost to operate the hiring
service. The annual depreciation rate of 10% is applied to fixed assests, i.e. drilling rigs, air
compressors, mud pumps and pumping test units, in accordance with the Executive Agencies
Project, Drilling and Dam Construction Agency, Accounting Manual - IFMS (2002). A
straight-line method is applied to calculation of depreciation to write off the cost of these assets
for a 10-year economic life.
6) Selling, General and Administrative Expenses
The allowance for the management team for monitoring visits is calculated with the basis of six
days per quarter per person. It is assumed that two senior staff members will visit the hirers’
drilling sites in a team or separately to oversee services provided by the technical instructors.
The indirect cost also includes the allowance for mechanics who will attend repair works and
services of the hired equipment on site when necessary. It is estimated that the mechanics will
be involved in these field works for 30% of the operation days of six drilling rigs.
Other expenses such as staff salaries, utilities, office rent, and cost for staff training are
calculated as the proportion to the direct cost so that the total of the indirect cost accounts for
approximately 30% of the direct cost. It is difficult to estimate more accurate amount of the
selling, general and administrative expenses at this stage as the current practice of cost
accounting by DDCA does not consider how the indirect cost is distributed to each type of
service the Agency operates. The budgeting method of the indirect cost should be reviewed
based on the actual cost accounting by services as well as departments.
43
Guideline on Hiring of Drilling Equipment
(2) Revenue
The revenue is estimated as shown in Table 20 based on the proposed rental fee and operation days
of each equipment for hiring. The expected revenue from the hiring service is approximately Tsh
1,545 million.
Table 20 Estimated Annual Sales
Annual Sales/
Annual Total
Item
Q'ty
Unit (Tsh)
Sales (Tsh)
1)
Truck mounted drilling rig
154,933,408
6
929,600,448
2)
Trailer mounted air compressor
23,207,440
5
116,037,200
3)
Trailer mounted mud pump
18,255,072
5
91,275,360
4)
Trailer mounted pumping test unit
55,969,488
5
279,847,440
5)
Rig accessories
12,075,312
6
72,451,872
6)
Casing tools
3,772,944
6
22,637,664
7)
Fishing tools
820,336
6
4,922,016
Direct mud circulation drilling tools &
8)
accessories
4,822,896
6
28,937,376
Total
273,856,896
1,545,709,376
11.2 PRICING POLICY
Rental fees of the equipment for hiring is set with considering costs, as listed below, for operation
of the service and a certain percentage of markup. Decpreciation cost will also be recovered from
the rental fee so that DDDCA will put aside a certain proportion of fund for replacement of the
equipment in the future.
Maintenance costs of the equipment
Fuel and lubricants
Consumables
Allowance
Advertisement
Stationary
Depreciation
Other administrative expenses
Market prices for hiring of drilling rigs and other construction machinery in Tanzania are aslo
referred in order to check if the proposed rental fees are kept at a reasonable level in comparison
with competitors. Figure 32 shows a formula used for calculation of the rental fees. Table 21
and Table 22 further indicate acquisition costs of the equipment and proportion of the hiring service
cost, respectively. The proportion of the service cost is calculated to obtain the ratio of
management cost, i.e. fuel and lubricants, consumables, and allowance for technical instructors and
drivers, to the unit cost of equipment and that of the selling, general and administrative cost to the
direct cost.
The daily rental fee of each item of the equipment is proposed in Table 23, which cost structure is
shown in Table 24. The prices are set at daily basis and to be charged to for the hiring period
which starts when the equipment is moved out from DDCA’s yard and ends when the same is
retuned to the Agency. The hirer has to pay the rental fee during the hiring period even if the
equipment is not operated on site. This is due to consideration of the opportunity cost of the
equipment as well as personnel cost for technical instructors and drivers.
44
Guideline on Hiring of Drilling Equipment
The rental fees without inclusion of depreciation of the equipment and those cost structures are also
provided in Table 25 and Table 26 for reference. It is desired that the investment cost for the
equipment is recovered from the rental fees by including the depreciation cost into the price
calculation since DDCA needs to secure own funds for replacement of the equipment for hiring
even though there is no allocation of subventions from MoW.
Taking the following points into account, DDCA will review pricing of the rental fees and set
strategically appropriate prices;
Willingnes to pay by different types of potential clients for the hiring service
Level of reasonable profit to sustain the business
Measures to minimize costs to secure the reasonable profit within the price set in
consideration of the willingness to pay by potential clients
Figure 32 Formula for Pricing of Rental Fee
Table 21 Acquisition Cost of Equipment for Hiring
Item
Unit Cost (US$)
Q'ty
Total (US$)
Note
1)
Truck mounted drilling rig
260,894.00
6
1,565,364.00
2)
Trailer mounted air compressor
39,081.00
5
195,405.00
3)
Trailer mounted mud pump
153,700.00
5
768,500.00
4)
Trailer mounted pumping test unit
94,247.00
5
471,235.00
excluding items categorized as
5)
Rig accessories
39,558.73
6
237,352.38
consumables
excluding items categorized as
6)
Casing tools
10,580.65
6
63,483.90
consumables
7)
Fishing tools
2,538.39
6
15,230.34
Direct mud circulation drilling
8)
tools & accessories
13,522.34
6
81,134.04
excluding items categorized as
Total
3,397,704.66
consumables
Table 22 Proportion of Hiring Service Cost
With Depreciation
Without Depreciation
Category for Pricing
Note
Amount (Tsh)
Proportion
Amount (Tsh)
Proportion
Depreciation
381,712,640
41.9%
0
0%
Maintenance Cost
155,323,200
17.0%
155,323,200
37.2%
Fuel & lubricants,
Management Cost
165,383,217
18.1%
165,383,217
39.6%
consumables, and allowance
Selling, General &
Administrative Expense
209,588,145
23.0%
96,904,540
23.2%
Total
912,007,202
100%
417,610,957
100%
Ratio of Management Cost
to Equipment Cost
3.0%
3.0%
Ratio of SGA to Direct Cost
29.8%
30.2%
45
Guideline on Hiring of Drilling Equipment
Table 23 Rental Fee of Drilling Equipment (with Depreciation Cost Considered)
(a)
(b)
(c )
(d)
(e)
(f)
(g)
(h)
(i)
(X)
Rental Fee
Unit Cost of
Risks for
Daily
Economic
Maintena
Managem
Operation
Net
Daily Rental
per
Item
Equipment
Depreciation
Exchange
SGA
Rental Fee
Life
nce Cost
ent Cost
Day/Year
Profit
Fee (USD)
Borehole
(US$)
Rate
(Tsh)
(Tsh)
1)
Truck mounted drilling rig
260,894.00
100%
10
3.5%
3.0%
10%
197
30%
10%
491.54
786,464
4,718,784
Trailer mounted air
2)
compressor
39,081.00
100%
10
3.5%
3.0%
10%
139
30%
10%
104.35
166,960
3)
Trailer mounted mud pump
30,740.00
100%
10
3.5%
3.0%
10%
59
30%
10%
193.38
309,408
Trailer mounted pumping
4)
test unit
94,247.00
100%
10
3.5%
3.0%
10%
69
30%
10%
506.97
811,152
5)
Rig accessories
39,558.73
0.6%
3.0%
10%
197
30%
10%
38.31
61,296
367,776
6)
Casing tools
10,580.65
2.9%
3.0%
10%
197
30%
10%
11.97
19,152
114,912
7)
Fishing tools
2,538.39
1.4%
3.0%
10%
79
30%
10%
6.49
10,384
Direct mud circulation
8)
drilling tools & accessories
13,522.34
2.9%
3.0%
10%
59
30%
10%
51.09
81,744
(Exchange Rate: 1USD = Tsh 1,600)
Rental Fee of a Drilling Rig with Rig Accessories and Casing Tools per Borehole: Tsh 5,201,472
Item 5), 6) and 8) above contain only accessories and tools to be attached to the drilling rigs for hiring. Consumables are not included.
Table 24 Structure of Rental Cost of Drilling Eqiupment (with Depreciation Cost Considered)
Depreciation
Maintenance
Management
Risks for Exchange
Annual Total
Daily Rental Fee
Item
SGA
Net Profit
Cost
Cost
Cost
Rate
Cost
(USD)
1)
Truck mounted drilling rig
26,089.40
9,131.29
7,936.88
26,089.40
20,661.95
6,924.70
96,833.62
491.54
2)
Trailer mounted air compressor
3,908.10
1,367.84
1,188.92
3,908.10
3,095.09
1,037.30
14,505.35
104.36
3)
Trailer mounted mud pump
3,074.00
1,075.90
935.17
3,074.00
2,434.51
815.91
11,409.49
193.38
4)
Trailer mounted pumping test unit
9,424.70
3,298.65
2,867.17
9,424.70
7,464.05
2,501.52
34,980.79
506.97
5)
Rig accessories
0
237.35
1,203.45
3,955.87
1,610.26
539.67
7,546.60
38.31
6)
Casing tools
0
306.84
321.88
1,058.07
503.31
168.68
2,358.78
11.97
7)
Fishing tools
0
35.54
77.22
253.84
109.39
36.66
512.65
6.49
Direct mud circulation drilling
8)
tools & accessories
0
392.15
411.37
1,352.23
643.23
215.58
3,014.56
51.09
46
Guideline on Hiring of Drilling Equipment
Table 25 Rental Fee of Drilling Equipment (without Depreciation Cost Considered)
(a)
(b)
(c )
(d)
(e)
(f)
(g)
(h)
(i)
(X)
Rental Fee
Unit Cost of
Risks for
Daily
Economic
Maintena
Managem
Operation
Net
Daily Rental
per
Item
Equipment
Depreciation
Exchange
SGA
Rental Fee
Life
nce Cost
ent Cost
Day/Year
Profit
Fee (USD)
Borehole
(US$)
Rate
(Tsh)
(Tsh)
1)
Truck mounted drilling rig
260,894.00
3.5%
3.0%
10%
197
30.2%
10%
307.18
491,488
2,948,928
Trailer mounted air
2)
compressor
39,081.00
3.5%
3.0%
10%
139
30.2%
10%
65.21
104,336
3)
Trailer mounted mud pump
30,740.00
3.5%
3.0%
10%
59
30.2%
10%
120.85
193,360
Trailer mounted pumping
4)
test unit
94,247.00
3.5%
3.0%
10%
69
30.2%
10%
316.82
506,912
5)
Rig accessories
39,558.73
0.6%
3.0%
10%
197
30.2%
10%
38.41
61,456
368,736
6)
Casing tools
10,580.65
2.9%
3.0%
10%
197
30.2%
10%
12.01
19,216
115,296
7)
Fishing tools
2,538.39
1.4%
3.0%
10%
79
30.2%
10%
6.51
10,416
Direct mud circulation
8)
drilling tools & accessories
13,522.34
2.9%
3.0%
10%
59
30.2%
10%
51.23
81,968
(Exchange Rate: 1USD = Tsh 1,600)
Rental Fee of a Drilling Rig with Rig Accessories and Casing Tools per Borehole: Tsh 3,432,960
Item 5), 6) and 8) above contain only accessories and tools to be attached to the drilling rigs for hiring. Consumables are not included.
Table 26 Structure of Rental Cost of Drilling Eqiupment (without Depreciation Cost Considered)
Depreciation
Maintenance
Management
Risks for Exchange
Annual Total
Daily Rental Fee
Item
SGA
Net Profit
Cost
Cost
Cost
Rate
Cost
(USD)
1)
Truck mounted drilling rig
0
9,131.29
7,936.88
26,089.40
13,040.48
4,315.76
60,513.81
307.18
2)
Trailer mounted air compressor
0
1,367.84
1,188.92
3,908.10
1,953.42
646.49
9,064.77
65.21
3)
Trailer mounted mud pump
0
1,075.90
935.17
3,074.00
1,536.50
508.51
7,130.08
120.85
4)
Trailer mounted pumping test unit
0
3,298.65
2,867.17
9,424.70
4,710.83
1,559.05
21,860.40
316.82
5)
Rig accessories
0
237.35
1,203.45
3,955.87
1,630.66
539.67
7,567.00
38.41
6)
Casing tools
0
306.84
321.88
1,058.07
509.68
168.68
2,365.15
12.01
7)
Fishing tools
0
35.54
77.22
253.84
110.77
36.66
514.03
6.51
Direct mud circulation drilling
8)
tools & accessories
0
392.15
411.37
1,352.23
651.38
215.58
3,022.71
51.23
47
Guideline on Hiring of Drilling Equipment
11.3 BREAK-EVEN ANALYSIS
The break-even point in sales is obtained to estimate the minimum requirement of the annual
operation days of one drilling rig. Table 27 shows the estimated income and profit based on the
revenue and expenditure indicated in Section 11.1. Items in the sales cost and administrative
expenses are further categorized into the fixed cost and variable cost. The break-even point in
sales can be calculated with the formula mentioned below;
Break-Even Point (in Sales) = Fixed Cost / 1 - (Variable Cost / Total Sales)
In case of the proposed business operation model, the break-even point in sales is approximately
Tsh 733.4 million which is equivalent to the sales from hiring of drilling rigs for 846 unit days.
The minimum requirement of the operation days of one drilling rig is, therefore, 141 days per
annum to meet the break-even point. The business operation would suffer a loss if the hiring
period of a drilling rig falls below 141 days a year. Figure 33 shows estimated sales cost as well
as profit or loss according to increase of the total of sales.
Table 27
Estimated Income and Profit
Fixed
Variable
Proportion
Item
Amount (Tsh)
Cost
Cost
to Sales (%)
Revenue from Hiring Service
1,545,709,376
Total of Sales
1,545,709,376
100%
Depreciation of Equipment for Hiring
x
381,712,640
24.7%
Maintenance Cost of Equipment
x
155,323,200
10.0%
Fuel and Lubricants
x
9,586,657
0.6%
Consumables for Drilling Rigs
x
9,306,560
0.6%
Allowance
x
146,490,000
9.5%
Total Cost of Sales
702,419,057
45.4%
Gross Profit
843,290,319
54.6%
Allowance for Management Team for
Monitoring
x
3,120,000
0.2%
Allowance for Mechanic
x
15,975,000
1.0%
Advertisement on New Service
x
600,000
0.0%
Stationery (A4 paper)
x
240,000
0.0%
Other expenses
x
189,653,145
12.3%
Total of Administrative Expenses
209,588,145
13.6%
Net Operating Profit/ Loss
633,702,174
41.0%
Total of Fixed Costs
572,205,785
Total of Variable Costs
339,801,417
Variable Cost Ratio
22.0%
Break Even Point (in Sales)
733,442,250
Break Even Ratio
47.5%
No. of Operation Days of Drilling Rig to Achieve BEP
846
days
No. of Operation Days of 1 Drilling Rig to Achieve BEP
141
days
48
Draft2 Guidelines for Hiring Equipment Maintenance System
Figure 33 Break-Even Point in Sales
11.4 ACCOUNTING
DDCA is responsible to open and operate a special account for all transactions related to the
equipment hiring service. The account shall be audited by Controller and Auditor General (CAG)
or his appointee. In order to comply with Regulation 29 of Public Finance Act, the draft annual
accounts should be ready latest by 15th September every year. The Annual Accounts shall be
prepared on accrual basis in accordance with international/national standard format specified in the
accounting manual.
In addition to the financial accounting required by the relevant laws and regulations, it is desired
that DDCA will employ cost control as well as calculation of profits and losses by activity as a part
of the managerial accounting.
11.5 INVESTMENT PLAN
Sustainable operation of the hiring service requires both augmentation and replacement of the
equipment to respond to demand by potential clients. Although MoW has not yet made it clear
about a plan to purchase the remaining 12 units of drilling rigs in the subsequent phases of WSDP,
it will be an opportunity for DDCA to increase available service options. DDCA will analyze
demand of different types of clients and review combination of options of the equipment hiring and
technical instruction. The Agency should approach MoW to procure appropriate types and
specificaitons of equipment which will meet such service options.
49
Ministry of Water (MoW)
Drilling and Dam Construction Agency (DDCA)
Japan International Cooperation Agency (JICA)
DDCAP
Manual on Hiring of Drilling
Equipment and Machinery
Version 1
March 2013
Groundwater Development and Management Capacity Development (DDCAP)
Project
Table of Contents
1. Purpose and Intended Users of the Manual
1
2. Planning
1
2.1 Preparation of Annual Plan
1
2.2 Budgeting
2
3. Business Promotion
4
4. IdentificatIon of Clients
4
5. Process of Equipment Hiring
4
6. Appraisal of Applications
7
7. Contract Management
7
8. Allocaiton of Staff to be Attached to the Hired Equipment
8
9. Maintenance
8
9.1 Demarcation of Responsibilities in Maintenance of the Hired Equipment
8
9.2 Preventive Maintenance
9
9.3 Inspection and Maintenance of Returned Equipment
9
10. Handling of Accident
9
10.1 Insurance
9
10.2 Handling of Accident Cases
9
11. Information Management on Client
9
12. Financial Management
10
12.1 Accounting
10
12.2 Reporting
10
13. Asset Management
10
13.1 Procurement of Consumables
10
13.2 Replacement Procurement of Drilling Equipment
10
14. Performance Monitoring
10
List of Tables
Table 1 Parameters for Calculation of Standard Operation Days of Equipment
1
Table 2 Formula for Calculation of Standard Operation Days of Equipment
2
Table 3 Cost items to be Considered in Expenditure Budget
3
Table 4 Procedures of Equipment Hiring
6
Table 5 Performance Indicators of the Equipment Hiring Service
10
List of Figures
Figure 1 Formula for Pricing Rental Fee
2
Figure 2 Process of Equipment Hiring
5
Manual on Hiring of Drilling Equipment
1. PURPOSE AND INTENDED USERS OF THE MANUAL
This manual is intended to describe the business flow and procedures of daily operation of the
hiring service of drilling equipment. It supplements the Gudelines on Hiring of Drilling
Equipment which explains the business model and operation principles of the hiring service by
DDCA.
This manual is the property of DDCA and to be used by authorized officers of the Agency only.
Amendments and additions on the manual will be issued from time to time by the Business Support
Manager after approval by the management of DDCA and Ministerial Advisory Board (MAB).
Hiring Business Unit is responsible to keep all editions of the manuals approved.
2. PLANNING
2.1 PREPARATION OF ANNUAL PLAN
The annual plan of the hiring service is the basis for budgeting the business operation in the year.
Annex 1 shows a form for annual plan of operation of hiring service. The plan should include,
but not limited to, the following contents;
(1) Basis of Calculation of Standard Operation Days of Equipment
The standard operation days of each type of equipment shows the estimated number of days for
which one item of the equipment is to be hired annually. These are calculated in order to estimate
expenditure budget. Parameters to be used for calculation of the standard operation days of
equipment are shown in Table 1. Historical records of the business operation are important
reference data to set these parameters in order to make the plan more accurate.
Table 1 Parameters for Calculation of Standard Operation Days of Equipment
Parameter
Reference Data
1.
Calculated Annual Operation Ratio per Rig
1)
No. of days for maintenance per year
Historical records
2)
No. of days for transport between sites per year
Historical records
3)
Standby period of the equipment at DDCA yard per year
Historical records
4)
Total of non-operation days per rig per year
= 1.1) + 1.2) +1.3)
5)
Operation days per rig per year
= 365 days - 1.4)
6)
Average No. of days required to drill a well
Baseline survey (6 days/well),
Historical records
7)
Average No. of wells which can be drilled per one rig per
= 365 days / 1.6)
year
2.
Assumption of Number of Hiring Contract per Rig
1)
No. of wells to be drilled in one contract
Historic records
2)
No. of contract per rig
= 1.7) / 2.1)
3.
Assumption of Proportion of Drilling Method to be
Applied
1)
Use of DTH method
Historical records
2)
Use of mud drilling method
Historical records
3)
Success rate of borehole drilling
Historical records
(2) Standard Operation Days of Equipment
Once the basis of calculation is set, the standard operation days of each item for hiring can be set as
mentioned in Table 2.
1
Manual on Hiring of Drilling Equipment
Table 2 Formula for Calculation of Standard Operation Days of Equipment
Item
Calculation*
1)
Truck mounted drilling rig
= 1.5)
2)
Trailer mounted air compressor
= 1.6) x 3.1) x 1.7)
3)
Trailer mounted mud pump
= 1.6) x 1.7) x 10%
4)
Trailer mounted pumping test unit
= 1.7) x 3.3) x 3 days/ well
5)
Rig accessories
= 1.5)
6)
Casing tools
= 1.5)
= 40% of the operation day of drilling rig
(The percentage should be reviewed based on
7)
Fishing tools
hiritorical records.)
Direct mud circulation drilling tools &
8)
accessories
= 1.6) x 1.7) x 3.2)
* The numbers in the column refer to the ones in Table 1.
(3) Equipment Arrangement Plan
Allocation of drilling rigs and other equipment among the headquarters and zonal offices should be
decided with considering the following points;
Geographical distribution of offices of potential hirers
Geographical distribution of demand of construction of boreholes
Capacity of each zonal office to attend repair and maintenance works
Information on the equipment arrangement plan will be used to estimate revenue and expenditure
by station of the equipment.
(4) Pricing
The rental fee of each item for hiring is set with applying the formula shown in Figure 1. Factors
listed below should also be considered to finally decide the prices;
Willingness to pay by different types of potential clients for the hiring service
Level of reasonable profit to sustain the business
Measures to minimize costs to secure the reasonable profit within the price set in
consideration of the willingness to pay by the potential clients
Reason why these additional factors should be taken into account is that the cost-based pricing
would result into decrease of sales itself if costs are reduced. In this situation, incentives to
minimize costs are undermined during the business operation. Therefore, willingness to pay by
different types of potential clients should be considered to set conditions of the service options
including the rental fees for each type of client.
Figure 1 Formula for Pricing Rental Fee
2.2 BUDGETING
The budget for operation of the hiring service is to be included in the annual budget proposal of
DDCA. For the budget preparation, reference should be made to accounting manuals of DDCA
for overall guidance. Items listed in Table 3 should be considered as expenditure budget. The
2
Manual on Hiring of Drilling Equipment
revenue budget should be prepared based on estimation of sales from hiring of each item of the
equipment with taking the standard operation days and proposed rental fees into account.
Table 3 Cost items to be Considered in Expenditure Budget
Cost Item
Note
I.
Direct Cost
1.
Maintenance Cost of
-
Approximately 3.5% of the equipment price is applied while the
Equipment
percentage should be reviewed based on historical records of the
maintenance cost.
-
Items consisting of rig accessories, casing tools, and direct mud
circulation drilling tools and accessories are categorized into 1) items
which are parmanently provided with the drilling rigs and 2)
consumables which use is optional for the hirer. Maintenance cost
should be considered for items grouped into 1) for these accessories
and tools.
2.
Fuel and Lubricants
-
The cost is to be considered 1) to drive carrier trucks for drilling rigs
between DDCA’s yard and client’s site as well as from one drilling
site to the other and 2) to conduct monitoring visit by the
management team.
-
Fuel cost for operation of the rig plant and other equipment do not
have to be included in the budget as hirers are responsbile to put fuel
on the hired equipment as they use.
3.
Consumables for Drilling
-
Items categorized into 2) mentioned in 1. Maintenance Cost are
Rigs
considered as consumables for drilling rigs. These items include
bits, DTH hammers, stabilizers, casing shoes, steel work casing, and
drill pipes.
-
DDCA will procure these items to keep as stocks for reselling to
hirers when necessary.
-
Minimum level of stock of each item should be decided based on
demand and historical records on sales of these items.
4.
Salary and Allowance for
-
Salaries and allowances for the technical instructors and drivers for
Staff to be Attached to Rigs
carrier trucks for drilling rigs are to be considered.
-
Working days on site is calculated as a total of standard operation
days and time to be take for transportation of drilling rigs.
5.
Depriciation of Equipment
-
The annual depreciation rate of 10% is applied to drilling rigs, air
for Hiring
compressors, mud pumps, and pumping test units in accordance
with the accounting manual of DDCA. The straight-line method is
applied to culculation of depreciation.
II.
Indirect Cost - Selling, General and Administrative Expenses
1.
Allowance for Management
- Frequency of the monitoring visit by the management team should be
Team for Monitoring
decided to estimate required amount of allowance.
2.
Allowance for Mechanic
- The cost is considered for the cases that mechanics are called for
repair and maintenance of the equipment on site.
- The number of working days on site should be estimated based on
historical records of such maintenance activities.
3.
Advertisement cost
- For printing brochures, advertising in newspaper or any other media
4.
Stationery
5.
Other Indirect Cost to be
Costs to be considered include, but not limited to, the following;
Partly Covered by Sales
- Salaries of administrative staff at the Hiring Business Unit and other
from the Hiring Service
departments/sections who are involved in administration and
management of the hiring service.
- Utilities
- Office rent
- Cost for training of staff of the Hiring Business Unit including the
technical instructors
Hiring Business Unit should formulate the annual operation plan including equipment allocation,
pricing and budgeting in consultation with Accounts Section, Procurement Section, Marketing and
Public Relations Section, Maintenance Section, and zonal offices.
3
Manual on Hiring of Drilling Equipment
3. BUSINESS PROMOTION
Business promotion of the hiring service should be planned in the way that particular information
reaches to specific (groups of) clients rather than treating the whole potential clients in same
manner. Messages to be delivered and media to be used for the publicity should be chosen with
considering characteristics of the potential clients.
Options of media for the advertisement are as follows;
Mailing brochures to identified companies
Introducing the service contents in regular and/or extraordinary meetings of Drilling
Association of Tanzania (DAT) and Contractors’ Registration Board (CRB)
Advertising on newsletters of CRB for its members
Advertising on newspaper
After deciding messages to be delivered to potential clients and means of publicity, materials for
the advertisement should be designed and produced. Annex 2 shows a sample brochure of the
hiring service which is meant to be used during the lead time for launch of the service once all the
details on the equipment and rental fees are confirmed.
Hiring Business Unit should prepare the plan for business promotion in cooperation with
Marketing and Public Relations Section.
4. IDENTIFICATION OF CLIENTS
Annex 3 contains a contact list of private drilling companies and other entities which operate
drilling works. These organizations were identified through the baseline survey of the private
drilling companies. Although some of them were confirmed to be no longer in operation of the
drilling works or not found about the status of their business due to unavailability of contact
addresses, information on the list should be updated if there are any changes observed in the
process of business promotion.
While iformation on the identified potential clients are maintained and updated, new clients should
also be cultivated continuously. Information listed below can be referred to identify new potential
clients;
List of drilling companies holding water well drilling license issued by MoW
CRB Directory
Advertisement on newspaper
Telephone directory
Information from zonal offices of DDCA on drilling companies operating in respective zones
5. PROCESS OF EQUIPMENT HIRING
Figure 2 shows process of the equipment hiring starting from inquiries from potential clients up to
return of the rented items. Administrative procedures to be followed in each stage of the process
are summarized in Table 4.
4
Manual on Hiring of Drilling Equipment
Figure 2 Process of Equipment Hiring
5
Manual on Hiring of Drilling Equipment
Table 4 Procedures of Equipment Hiring
Process
Procedure
-
Confirm if the requested equipment is available for the period inquired.
1. Prepare
-
Provide a quotation if the item is available or write an advice on available
Quotation
period of the equipment if it is to be occupied.
-
Receive an order and application form from a client.
2. Examin
-
Make an appraisal of the application based on the checklist to confirm if
Application
the client satisfies qualifications.
-
Advise restuls of appraisal to the client.
-
Prepare a rental contract.
-
If some conditions need to be changed or added to the standard contract
3. Sign a Rental
form, consult with a Legal Officer on the conditions.
Contract
-
Explain terms and conditions to the client.
-
Sign two originals of the contract and give one to the client while the
oher to be filed.
4. Charge and
-
Prepare a bill for an advance payment.
Collect Advance
-
Confirm receipt of an advance payment.
Payment
5-1. Organize
-
Inform a driver and technical instructor on the hiring period of the
Personnel to be
drilling rig, drilling sites, and particulars of the cllient.
Attached to the Rig
-
Make arrangement of allowance for the staff.
-
Submit a hiring equipment order form to Maintenance Section to inform
of the equipment to be hired, the hiring period, drilling sites, and
particlulars of the client.
-
Install necessary accessories and tools according to the order.
5-2. Prepare Rental
-
Refuel the carrier truck for rig palnt.
Equipment
-
Check conditions of the equipment according to the equipment checklist.
-
Make sure that the equipment is services, cleaned and ready for hand
over to the client.
-
Take photos of the equipment to be hired to record its condition before
hiring.
6-1. Mobilize
-
Receive a signature from the client on the hiring equipment order slip
Drilling Rig to
and equipment checklist.
Client’s Site
-
Start with the client to drilling site.
-
Receive a signature from the client on the hiring equipment order slip
6-2. Hand Over
and equipment checklist.
Other Equipment to
-
Hand over all items ordered.
Client at DDCA
-
Provide the client with a maintenance manual for hirer with daily service
Yard
check sheet and explain salient points on the daily service.
6-3. Provide
-
The technical instructor gives advice on drilling works to the team from
Technical
the client.
Instruction on
-
The technical instructor records observations on skills of the drilling
Operation of
team and management of the drilling works by the client in an on-site
Drilling Works
checklist of drilling technical level.
6-4. Supervise Use
-
The technical instructor gives advice to the drilling team from the client
and Maintenance of
on daily maintenance activities and safety measure to operate the
Equipment on Site
equipment.
-
The technical instructor informs Business Hiring Unit of damages on the
equipment which requires repair works by a mechanic from DDCA.
6-5. Dipatch
-
Inform Maintenance Section of condition of the equipment and other
Mechanic and
details.
Repair Equipment
-
Make arrangement of allowance and means of transport for the mechanic.
on Site
-
Send the mechanic to client’s site.
-
The mechanic attend the repair works and record the works conducted in
the maintenance record of the equipment.
7-1. Demobilize
-
The driver demobilizes the drilling rig from the site.
the Eqiupment
-
Receive all the equipment from the client at DDCA yard.
Back from Site and
6
Manual on Hiring of Drilling Equipment
Process
Procedure
Receive at DDCA
Yard
-
Receive a signature from the client on a returning slip.
-
Check condition of the equipment according to the equipment checklist
and record any defects which were not observed before hiring.
7-2. Check
-
Take photos of the equipment to record its condition after hiring.
Condition of
-
Confirming the condition of the equipment by comparing the “hiring
Returned
equipment check list (before and after hiring)” and the photos of the
Equipment
hiring equipment (before and after hiring)
-
Receive a signature from the client on the equipment checklist which
describes condition of the equipment after hiring.
-
Wash and clean the equipment.
8. Conduct
-
Inspect the equipment in accordance with the periodic service checklist.
Equipment
-
Repair damages or defects on the equipment.
Maintenance/
-
Inform Business Hiring Unit of necessity of procurement of accessories,
Repair
tools, or spares of the equipment, if any
-
Prepare a bill for remaining payment including repair cost incurred due to
misuse of the equipment by the client, if any.
9. Charge and
-
Send the bill to the client together with 1) feedback form from the client
Collect Balance of
and 2) a copy of hiring equipment checklist and photos showing
Contract Amount
condition of equipment before and after hiring in case that there are any
defects on the equipment caused from misuse by the client.
-
Confirm receipt of the payment.
10-1. Get Feedback
-
Collect a feedback form filled by the client.
from Client
-
Check if any acitons should be taken to claims raised by the client.
-
Collect the on-site checklist of drilling technical level and report from the
10-2. Get Report
technical instructor.
from Technical
-
Confirm with the technical instructor if any actions should be taken to
Instructor
improve service provision.
6. APPRAISAL OF APPLICATIONS
Hiring Business Unit will make an appraisal of each application form for the equipment hiring
submitted by clients. The purpose of the appraisal is to screen qualified drilling companies which
satisfy conditions mentioned below;
To possess a valid water well drilling permit issued by MoW.
To be registered as the specialist contractor at CRB.
To have at least one permanent employee among the drilling staff to be on site
with the hired equipment and to receive the technical instructions from DDCA.
Annex 6 and Annex 8 show an application form for the equipment hiring and checklist for
appraisal of applications, respectively. In case that the applicant does not meet the conditions on
possession of drilling permit and/or registration at CRB, Hiring Business Unit should give advice
to the company to consult with the respective authorities for required procedures.
7. CONTRACT MANAGEMENT
7
Manual on Hiring of Drilling Equipment
The contract management involves the following procedures;
Preparation of the standard contract form
Preparation of a contract for each case of hiring
Signing of the contract
Billing and collection of payment
Check of fulfillment of terms and conditions by both parties
Claim on implementation of obligations of the hirer
Preparation and revision of the standard contract form should be done in consultation with Legal
Officers of DDCA. Further advice can also be obtained from Legal Unit of MoW when
necessary.
Once the appraisal of the application form is completed and the hirer is selected, Hiring Business
Unit prepares a rental contract of the equipment. A sample contract form is attached in Annex 9.
Particulars on the hirer, equipment to be hired, hiring period and charges should be filled in the first
page of the contract form while general conditions of the contract is to be stipulated in the
following pages.
8. ALLOCAITON OF STAFF TO BE ATTACHED TO THE HIRED
EQUIPMENT
One driver and technical instructor will be attached to each drilling rig to be hired. Roles of these
personnel should be referred to the Guideline on Hiring Drilling Equipment. The technical
instructors will provide guidance and advice to the drilling team of the client on operation of
drilling rigs and implementation of the works on site in accordance with the Capacity Development
Support Plan for the Private Sector and Technical Manual for Drilling Works.
The technical instructors should record the on-site checklis of the drilling technical level based on
observations of works conducted by the client’s drilling team. The technical instructors should
also prepare a report on technical instruction to be submitted to Hiring Business Unit after
completion of the hiring period. Annex 10 shows a report from on technical instruction
9. MAINTENANCE
9.1 DEMARCATION OF RESPONSIBILITIES IN MAINTENANCE OF THE HIRED EQUIPMENT
DDCA will be responsible for preventive maintenance and repair works of the equipment before
the equipment is hired and after the items are returned from the hirer. Maintenance Section
conducts necessary maintenance works in accordance with the guidelines, plan and manuals for
maintenance system of the equipment for hiring which are formulated separately.
On the other hand, the hirer will conduct routine maintenance of the hired equipment on site under
supervision of the technical instructor from DDCA. DDCA will provide the hirer with a
maintenance manual for hirer with daily service check sheet which describes procedures of daily
maintenance check and safety measures. The hirer wil bear the costs to be incurred for routine
maintenance and repairs required during operation of the equipment on site.
For any mechanical troubles which cannot be attended by the drilling staff from the hirer or
technical instructor, DDCA will send a mechanic to the site either from the headquarter or the
nearest zonal office. When any damages or defects occur on the equipment and repair works by
the mechanic are required, the technical instructor will inform Hiring Business Unit of details on
8
Manual on Hiring of Drilling Equipment
condition of the equipment upon confirmation with the hirer. Costs to remedy damages or defects
caused on the equipment by misuse of the hirer should be borne by the hirer.
9.2 PREVENTIVE MAINTENANCE
Maintenance Section is responsible to conduct preventive maintenance of the equipment for hiring
to keep it in good condition. The Maintenance Guidelines and Manual should be referred to for
implementation of the preventive maintenance works.
9.3 INSPECTION AND MAINTENANCE OF RETURNED EQUIPMENT
Using the equipment checklist (Annex 11), Maintenance Section will check condition of the
equipment to be hired before handing over to the hirer and after receiving it. Pictures of the
equipment should be taken to record condition of before and after the hiring in order to check if any
damages or defects occur on the equipment during the hiring period.
Maintenance Section will send a mechanic to the client’s site to attend repair works when Hiring
Business Unit requests it upon receipt of notice of breakdown of the equipment. The mechanic
will fill in the maintenance record describing problems, causes, repair works conducted, and spares
replaced.
In case that the hiring period extends more than one month, Hiring Business Unit will make an
arrangement to dispatch a mechanic to the client’s site to get the equipment serviced even if there is
no breakdown or defect reproted.
10. HANDLING OF ACCIDENT
10.1 INSURANCE
This section will be finalized after DDCA decides demarcation of responsibility on insurance cost
based on consultation with MoW and Ministry of Finance and Economic Affairs.
10.2 HANDLING OF ACCIDENT CASES
The equipment to be hired should have a sticker on its body to clearly indicate that it belongs to
DDCA.
This section will be finalized after DDCA decides demarcation of responsibility on insurance cost
based on consultation with MoW and Ministry of Finance and Economic Affairs.
11. INFORMATION MANAGEMENT ON CLIENT
Hiring Business Unit will keep and update particulars of the clients and comments from them about
services provided by DDCA. Information to be maintained by the Unit includes, but not limited
to, the following;
Name, physical address and contact of the organization
Name and position of the representative person for contact
Year of acquisition/ renewal of the water well drilling permit issued by MoW
Registration No. of the specialist contractor at CRB
Records of equipment hired and hiring period
Contract amount
9
Manual on Hiring of Drilling Equipment
No. of boreholes drilled (both successful and unsuccessful) with the hired equipment,
drilling sites
Feedback from (Annex 12) from the client on technical instruction, condition and capacity of
equipment, rental fees, etc.
12. FINANCIAL MANAGEMENT
12.1 ACCOUNTING
Accounts Section is responsible for the financial accounting of the hiring service, which is
supposed to be conducted in accordance with the accounting manuals of DDCA. In addition to
the financial accounting required by the relevant laws and regulations, the cost control as well as
calculation of profits and lossess by the hiring service should be conducted by Business Hiring Unit
in conjunction with Accounts Section as a part of the managerial accounting.
12.2 REPORTING
Hiring Business Unit will compile the financial status of the hiring service based on sales and
expenditure records at Accounts Section and included it in the monthly reports.
13. ASSET MANAGEMENT
13.1 PROCUREMENT OF CONSUMABLES
Maintenance Section will report it to Hiring Business Unit when there is necessity to replace spare
parts and/or purchase accessories and tools of the equipment for hiring. Hiring Business Unit will
inform details on required items to Procurement Section for further arrangement to purchase them.
A procurement plan of the consumables should be prepared to ensure timely arrangement of the
required items.
13.2 REPLACEMENT PROCUREMENT OF DRILLING EQUIPMENT
Hiring Busienss Unit will make a plan for replacement of the equipment or procurement of new
items in consultation with Procurement Section and Accounts Section. Replacement of the
equipment should be implemented based on procedures for depreciation of the equipment and plant
stipulated in the accounting manual. For investment for new items of equipment, Hiring Business
Unit will analyse which type of equipment is required by different groups of clients.
14. PERFORMANCE MONITORING
Business Hiring Unit should prepare monthly reports on business operation not later than 10 days
after the end of every month. The report describes operational and financial status of the hiring
service. Annex 13 shows a monthly report form. The Unit should compile an annual report
based on the monthly reports and submit it not later than 14 days afte the end of every year.
Performance indicators listed in Table 5 should be used for monitoring and reporting.
Table 5 Performance Indicators of the Equipment Hiring Service
Frequency of
Purpose
Indicators
Means of Verification
Monitoring
1-1. Drilling equipmemt is hired in
1-1. R
1. Process
accordance with the
ec
Management
procedures established.
or
1-2. All drilling equipment for
ds
10
Manual on Hiring of Drilling Equipment
Frequency
of
Purpose
Indicators
Means of Verification
Monitoring
hiring is maintained in
fo
accordance with the
r
maintenance plan.
hi
1-3. Internal management
ri
accounting document for
n
hiring is reported periodically
g
to the management.
1-2. M
ai
nt
en
an
ce
re
co
rd
s
of
dr
ill
in
g
eq
iu
p
m
en
t
fo
r
hi
ri
n
g
1-3. R
ep
or
ts
o
n
hi
ri
n
g
se
rv
ic
e
2-1. The number of operation days of a
2-1. Records for hiring
2-1. Monthly
drilling rig for hiring reaches to 141 days
per annum on average, the break even
2. Managemenet
line of the hiring business1, by 2016.
2-2. Records for hiring
2-2. Monthly
of Output of
2-2. More than 80% of the registered water
the Service
well drilling companies utilize some
forms of the technical support services by
2-3. Feedback forms
2-3. Each hiring
2016.
from clients
conctract,
2-3. More than 80% of private drilling
Monthly
1 See Section 11.3 for an estimation of the break even line of the hiring business.
11
Manual on Hiring of Drilling Equipment
Frequency of
Purpose
Indicators
Means of Verification
Monitoring
companies, which used the technical
support services provided by DDCA,
consider that the services they received
helped their business activities.
3-1. The number of private companies which
3-1. Records for hiring,
3-1. Annually
use the technical support services of
Water Sector MIS
DDCA and participate in drilling works
in WSDP increases by 122% by 2018,
3. Management
compared to the status before official
of Outcomes
launch of the service provision.
3-2. MoW Annual
3-2. Annually
3-2. The number of wells planned in WSDP is
Water Sector
constructed by 2015.
Status Report,
Water Sector MIS
12
Manual on Hiring of Drilling Equipment
ANNEXES
1. FORM FOR ANNUAL PLAN OF OPERATION OF HIRING SERVICE
2. SAMPLE BROCHURE OF HIRING SERVICE
3. CONTACT LIST OF PRIVATE DRILLING COMPANIES
4. FORM FOR REQUEST FOR QUOTATION
5. QUOTATION FORM
6. APPLICATION FORM FOR HIRING OF DRILLING EQUIPMENT
7. ORDER FORM
8. CHECKLIST FOR APPRAISAL OF APPLICATIONS
9. SAMPLE CONTRACT FORM
10. FORM FOR REPORT ON TECHNICAL INSTRUCTION
11. CHECKLIST OF EQUIPMENT
12. FEEDBACK FORM FROM CLIENT
13. MONTHLY REPORT FORM
Manual on Hiring of Drilling Equipment
Annex 1 Form for Annual Plan of Operation of Hiring Service
Annual Plan of Operation of Hiring Service for (Year)
1. Items to be Hired and Equipment Arrangement Plan
Item
Specification
Qty
Station
2. Basis of Calculation of Standard Operation Days of Equipment
1.
Calculated Annual Operation Ratio per Rig
1) No. of days for maintenance
days/year
2) No. of days for transport between sites
days/year
3) Standby period
days/year
4) Total of non-operation days
days/year
=1)+2)+3)
5) Operation days
days/year
6) No. of days required to drill a well
days/well
7) No. of wells which can be drilled
wells/rig/year
2.
Assumption of Number of Hiring Contract per Rig
1) No. of wells to be drillied in one contract
wells
2) No. of contract per rig
/ year
3.
Assumption of Proportion of Drilling Method to be Applied
% of total number of wells to be
1) Use of DTH method
drilled
% of total number of wells to be
2) Use of mud drilling method
drilled
3) Success rate of drilling
%
3. Standard Operation Days of Equipment
No. of
Item
Qty
Operation Days
Calculation
per Annum
A-1
Manual on Hiring of Drilling Equipment
4. Pricing of Rental Fees
Price (Tsh)
Condition (if different prices are set
Item
for different service options)
5. Budget
5-1. Revenue
Annual Sales/
Annual Total
No.
Item
Q’ty
Unit (Tsh)
Sales (Tsh)
Total
5-2. Expenditure
Unit
No.
Item
Unit
Q’ty
Amount (Tsh)
Note
Cost
Direct Cost - Total
Indirect Cost - Total
Grand Total
A-2
Manual on Hiring of Drilling Equipment
Annex 2 Sample Brochure of Hiring Service (Front)
Drilling and Dam Construction Agency (DDCA)
We offer hiring service of drilling equipment
for water well construction
Truck Mounted Drilling Rig
Trailer Mounted Air
(6 units)
Compressor
(5 units)
Picture of the
Picture of the
Rotary cum DTH
650CFM, 246 psi
Equipment
Equipment
Maximum drilling depth 150m
Trailer Mounted Mud Pump
Trailer Mounted Pumping Test
(5 units)
Unit
(5 units)
Picture of the
Picture of the
20kg/cm2, 600 l/min.
Generator, riser pipe, submersible
Equipment
Equipment
pump
Bits, DTH hammer, drill pipes and other consumables are on sale from our stocks if you
need them.
The truck mounted drilling rig will be hired with a truck driver and technical instructor who
provides technical assistance and guidance on operation of the rig to your drilling team
including a rig operator on site. Per diem for the truck driver and technical instructor is
included in the rental fee. The owner (DDCA) is responsible for fuel for the carrier truck
of the rig plant during mobilization from and demobilization to DDCA’s yard and for
transportation among hirer’s sites.
The hirer (client) is responsible for fuel as used during the operation of the rig plant on site.
The hirer is also responsible to arrange carrier trucks and fuel for transportation of the
compressor, mud pump, and pumping test unit when these items are hired.
Support for Capacity Development of Your Drilling Team
Our technical instructors are specialized in providing hands on training
and guidance to drilling teams in various technical areas related to
Picture of technical instructors
drilling works. Such areas include drilling techniques, borehole
providing guidance to a drilling team
logging, casing program/ installation, gravel packing, well development,
on site
well investigation, tool fishing, well rehabilitation, puming test, and
water quality analysis. The technical instructors will help your staff
members in the drilling team enhance their skills to conduct quality
works with efficiency.
A-3
Manual on Hiring of Drilling Equipment
Annex 2 Sample Brochure of Hiring Service (Back)
- Conditions for Use of DDCA’s Equipment Hiring Service -
The drilling equipment for hiring was procured by the Ministry of Water to facilitate participation
of private drilling companies in works for exploratory drilling and development of production wells
under the Water Sector Development Program (WSDP) aiming at increase of water supply
coverage to 90% in rural area and 100% in urban area by 2025. DDCA operates the hiring service
of these drilling rigs and other equipment as a part of the technical support service for private
drilling companies. In the light of this background and expected outcomes from utilization of the
procured equipment, those who would like to use this hiring service are expected to satisfy the
following conditions as the hirer;
[Requirements to Applicants]
1. To possess a valid water well drilling permit issued by the Ministry of Water.
2. To be registered as a specialist contractor at the Contractors Registration Board (CRB).
3. To have at least one permanent employee among the drilling staff to be on site with the hired
equipment and to receive guidance from a technical instructor attached from the owner.
[Use of the Equipment]
The first priority is given to those who are going to use the equipment for drilling works funded by
WSDP or any other government-funded water supply projects. The equipment will also be made
available to those who work for borehole drilling financed by the private sector including
individual households.
Please consult with the Ministry of Water and CRB, respectively, for procedures required for
acquisition of a water well drilling permit and contracotor’s registration.
Submit
Receive
Mobilize
Return
Confirm
applicatio
Sign a
Settle
equipme
equipme
equipme
condition
Request
n form &
Settle the
rental
advance
nt at
nt and
nt to
of
quotation
order
balance
contract
payment
DDCA's
operate
DDCA's
equipme
form
yard
on site
yard
nt
Process of Equipment Hiring
For further information:
Hiring Business Unit
Drilling and Dam Construction Agency (DDCA)
Tel: +255-22-2410430 / 255-22-2410299
Fax: +255-22-2410430
Email:
P.O. Box 55658 Ubungo, Off University Road, Kinondoni, Dar es Salaam
A-4
Manual on Hiring of Drilling Equipment
Annex 3 Contact List of Private Drilling Companies
A-5
Manual on Hiring of Drilling Equipment
Annex 4 Form for Request for Quotation
Drilling and Dam Construction Agency
Request for Quotation
1.
Business Entity
Name
2.
Mailing Address
3.
Physical Address
Region:
District:
Ward:
Street:
Plot No.:
4.
Telephone/Mobile
5. Fax
6.
E-mail
7.
Contact Person
Name
Position
Phone
Hiring of Drilling Equipment
Hiring Period
Please
Item
Q’ty
Total
tick
Start
End
Days
Truck mounted drilling rig
Trailer mounted air compressor
Trailer mounted mud pump
Trailer mounted pumpint test unit
Rig accessories*
Casing tools*
Fishing tools
Direct mud circulation drilling
tools & accessories*
* Please refer to the attached list for items included in rig accessoris, casing tools and direct mud circulation
drilling tools and accessories.
Purchase of Consumables
Please
Description
Q’ty
tick
Drill pipes 41/2’’ 0.D flush type with API 31 1/2’’IF BOX and pin joints
furnished with wrech squares and steel made protectors,6m long/pc
DTH Hammer assembly for 6 1/4’’(150mm) hole drilling API 3 1/2
Regular pin and 8’’ to 10’’ hole drillling
DTH Hammer assembly for 12’’(300mm) hole drilling API 3 1/2 Regular
pin
DTH Button bit for 6 1/4’’(159mm) hole drilling
DTH Button bit for 8 1/4’’(216mm) hole drilling
DTH Button bit for 10’’(254mm) hole drilling
Tricone roller bits 6 1/2’’ dia
A13
Manual on Hiring of Drilling Equipment
Please
Description
Q’ty
tick
Tricone roller bits 8 1/2’’ dia
Tricone roller bits 10 1/2’’ dia
Tricone roller bits 12 1/2’’ dia
Roller bits 8 1/2’’ dia
Roller bits 10 1/2’’ dia
Roller bits 12 1/2’’ dia
Roller bits 14 1/2’’ dia
Drag bits three winged 8 1/2’’ dia
Drag bits three winged 10 1/2’’ dia
Drag bits three winged 12 1/2’’ dia
Stabilizer for 6 1/4’’ hole body dia,1.5m long API 3 1/2 IF BOX and pin
joints furnished with wretch squares and steel made thread protectors on
both ends
Stabilizer for 8 1/2’’ hole 5’’ body dia,1.5m long API 3 1/2 IF BOX and pin
joints furnished with wretch squares and steel made thread protectors on
both ends
Casing shoe for 8’’ casing
Casing shoe for 10’’ casing
Casing shoe for 12’’ casing
Any special instructions, comments, and other inquiries
Signature
Print Name
Date
RFQ No.
Date (Received)
Date (Replied)
Name
A-14
Manual on Hiring of Drilling Equipment
List of Rig Accessories and Tools Attached to the Drilling Rig
No.
Description
I. Rig Accessories
1
Drilling collars 5’’0.D,2’’IF BOX and pin joints,furnished with wretch
squares and steel protectors,6m long/pc
2
Hoisting swivel API 1/2’’ IF Pin joint
3
Hoisting plug API 1/2’’ IF Pin joint
4
Drill pipes collar hanger
5
Cross over sub API 3 1/2 IF BOX and pin
6
DTH Button Bit for 12’’(300mm) hole drilling
7
Bit sub for drill pipes/collar to 6 1/4’’ DTH Hammer API 3 1/2’’ Regular box
and API 3 1/2’’ IF Box joint
8
Bit sub for drill pipes/collar to 6 1/4’’ DTH Hammer API 3 1/2’’ Regular box
and API 3 1/2’’ IF Box joint
9
Bit
15rinder for button bit and body dressing,furnished with 15 m long high
pressure air hose
10
Drag bits three winged 16 1/2’’ dia
11
Roller bit 16’’ dia for soft formation
12
Stabilizer for 10’’ hole 5’’ body dia,1.5 long API 3 1/2 IF BOX and pin joints
furnished with wretch squares and steel made thread protectors on both
ends
13
Stabilizer for 12’’ hole 5’’ body dia,1.5m long API 3 1/2 IF BOX and pin
joints furnished with wretch squares and steel made thread protectors on
both ends
II. Casing Tools
1
Casing lamp with bolts,nuts,wrench and sling wire for 4’’ PVC casing ,3
pairs/sets
2
Casing lamp with bolts,nuts,wrench and sling wire for 6’’ PVC casing ,3
pairs/sets
3
Casing lamp with bolts,nuts,wrench and sling wire for 8’’ PVC casing ,3
pairs/sets
4
Casing lamp with bolts,nuts,wrench and sling wire for 10’’ PVC casing ,3
pairs/sets
5
Casing lamp with bolts,nuts,wrench and sling wire for 12’’ PVC casing ,3
pairs/sets
6
Casing head for 8’’ casing
7
Casing head for 10’’ casing
8
Casing head for 12’’ casing
9
Casing sub , API 3 1/2 IF BOX to 8 ‘’ casing
10
Casing sub , API 3 1/2 IF BOX to 10 ‘’ casing
11
Casing sub , API 3 1/2 IF BOX to 12 ‘’ casing
12
Casing hoist plug with sling wire for 8’’ casing
13
Casing hoist plug with sling wire for 10’’ casing
14
Casing hoist plug with sling wire for 12’’ casing
III. Direct Mud Circulation Drilling Tools & Accessories
1
Mud testing kit including mud balance ,marsh funnel,viscocity meter with
measuring cup sand content kit,stop watch and thermometer
2
Collapsible water tank with housing bag 3000 Litre capacity
3
Portable water level indicator,dry battery operated type,measuring
capacity of 200m
A15
Annex 5 Quotation Form
Drilling and Dam Construction Agency
Quotation
Date
Quotation No.
1.
Business Entity
Name
2.
Mailing Address
3.
Physical Address
Region:
District:
Ward:
Street:
Plot No.:
4.
Telephone/Mobile
5. Fax
6.
E-mail
7.
Contact Person
Name
Position
Phone
Hiring of Drilling Equipment
Hiring Period
Unit
Amount
Item
Q’ty
Total
Price
Start
End
(Tsh)
Days
(Tsh)
Total Amount
Purchase of Consumables
Unit Price
Item
Q’ty
Amount (Tsh)
(Tsh)
Total
Amount
A-16
Manual on Hiring of Drilling Equipment
Annex 6 Application Form for Hiring of Drilling Equipment
Drilling and Dam Construction Agency
Application for Hiring of Drilling Equipment
Section A: Applicant Information
1.
Business Entity
Name
2.
Mailing Address
3.
Physical Address
Region:
District:
Ward:
Street:
Plot No.:
4.
Telephone/Mobile
5. Fax
6.
E-mail
7.
Contact Person
Name
Position
8.
Year
of
9. Year of Starting of
Establishment
of
Drilling Operations
the Organization
10.
Business Type
[
]
Sole Proprietor
[
]
Partnership
[
]
Corporation
[
]
Not for Profit
[
]
Other
(specify:
)
11.
Contractors
Registration No.
Registration
Date of Registration
Board
(CRB)
Registration
12.
Water
Well
Permit No.
Drilling Permit No.
Date of Issuance/
Issued by Ministry
Renewal
of Water
Section B: Drilling Works to be Conducted with the Hired Equipment
1.
Owner of the
[
]
Government
[
]
Private Business Entity
Work
[
]
Individual Household
[
]
External Support Agencies
(Donor)
2.
Outline of the
No. of Production Wells to
Work
be Constructed with Hired
Rig(s)
Use of Water
[
]
Domestic water supply
[
]
Source
Irrigation
[
]
Livestock watering
[
]
Industrial use
[
]
Other
use
(specify:
)
Planned Service
[
]
Hand Pump
Options for Water
[
]
Piped Scheme with Public Taps
Supply
[
]
Piped Scheme with House Connections
3.
Drilling Team
No. and Position
of
Permanent Staff to be
Assigned in Drilling Team
Section C: Acknowledgement and Authorization
Signature
Print Name
Date
Please attach copies of CRB registration certificate and water well drilling permit.
Application No.
Date (Received)
Date (Replied)
Results of Appraisal
Name
A-17
Annex 7 Order Form
Drilling and Dam Construction Agency
Order Form / Rental Contract
1.
Business Entity
Name
2.
Mailing Address
3.
Physical Address
Region:
District:
Ward:
Street:
Plot No.:
4.
Telephone/Mobile
5. Fax
6.
E-mail
7.
Contact Person
Name
Position
(Office)
Phone
8.
Contact Person
Name
Position
(Site)
Phone
9.
Site Location
Region
District
Ward
Village/
Street
10.
Hiring Period
Start
End
11.
Special
Instructions
Hiring of Drilling Equipment
Hiring Period
Unit
Amount
Item
Q’ty
Total
Price
Start
End
(Tsh)
Days
(Tsh)
Total Amount
A-18
Manual on Hiring of Drilling Equipment
Purchase of Consumables
Unit Price
Item
Q’ty
Amount (Tsh)
(Tsh)
Total
Amount
Signature
Print Name
Date
This order form constitutes an Individual Contract for hiring of drilling equipment when
the Hirer signs and submits it to DDCA. General provisions on the rental contract are
stipulated in the general conditios of the drilling equipment rental contract.
Quotation No.
Application No.
Order Form No.
Date (Received)
Date (Replied)
Name
Technical Instructor
Driver
A-19
Annex 8 Checklist for Appraisal of Applications
Checklist for Appraisal of Applications for Use of Hiring Service
The application forms submitted by private drilling companies should be checked if all the
conditions specified below are satisfied;
1.
To possess a valid water well drilling permit issued by the Ministry of Water.
Is a copy of the permit attached to the application form?
Is the permit still within one-year valid period? (A permit issued/renewed in last or this
financial year should be submitted.)
2.
To be registered as the specialist contractor at the Contractors’ Registration Board.
Is a copy of the registration certificate from CRB attached to the application form?
Is the applicant regisetered as a Specialist Contractor?
3.
To have at least one permanent employee among the drilling staff to be on site with the hired
equipment and to receive the technical instructions from DDCA.
Is there at least one permanent staff included in the drilling team?
The Hiring Business Unit should send an applicant a written notice of results of appraisal of the
application within five (5) business days from recipt of the application form. The Unit will give
advice to the applicant who does not meet the conditions to consult with MoW and CRB to obtain
necessary permit/ registration.
A-20
Manual on Hiring of Drilling Equipment
Annex 9 Sample Contract Form
General Conditions on the Drilling Equipment Rental Contract
Article 1. General Provisions
1. The general conditions on the drilling equipment rental contract (hereinafter referred to as ‘the
contract’) determines its general provisions regarding the contractual relationship of the Owner
and the Hirer.
2. The Owner provides the rental of movable property and other related services under the
conditions stipulated in the agreement (rental and other services are hereinafter referred to as
‘rental’) to the Hirer.
Article 2. Individual Contract
1. Conclusion of a rental contract for each property
(hereinafter referred to as
‘Individual
Contract’) is done by the Hirer and the Owner in accordance to the agreement.
2. Individual Contracts will be effected when the Hirer submits a signed order sheet which clearly
defines necessary details such as the name of the property, quantity, hiring period, and place of
use, and when the Owner agrees with the request.
3. If there is a discrepancy between the conditions stipulated in the Individual Contract and the
agreement, the condition in the Individual Contract shall prevail.
4. Conditions regarding Individual Contracts will be determined by prior agreement between the
Hirer and the Owner.
Article 3. Hiring Period
1. The hiring period starts on the date the Hirer receives the property from the Owner (date of rental
commencement) and ends on the date the Hirer returns it to the Owner (date of rental
termination).
2. A written consent of the Owner is required for the extension or reduction of the hiring period.
Article 4. Rental Fee
1. The rental fee generally refers to the ‘rental charges’ of the property.
2. The Hirer shall pay the Owner the rental fee for the agreed hiring period even if there is a period
where the Hirer, for any reason or circumstance, does not, or is unable to, use the property.
3. In principle, the rental fee is charged for eight (8) hours of use of the property per day. When
the property use exceeds eight (8) hours, extra fees will be incurred.
Article 5. Guaranty Deposit
1. The Owner is entitled to request the Hirer a guaranty deposit to guarantee fulfilment of
obligations of the Hirer stated in the contract. The Hirer shall deposit the requested amount of
guaranty upon a request from the Owner. The guaranty deposit shall not incur interest.
2. When any of the items described in Article 19, under Clause 1, applies to the Hirer, the Owner
shall appropriate the guaranty deposit for settlement of the outstanding balance and financial
obligation of the Hirer, including rental fees.
Article 6. Permits
The Hirer shall at its own expense apply for and obtain any permits, licenses, certificates,
permission, or exemptions which may be required for and in connection with the entry and use of
the property on the site. The Owner shall be responsible for any permits, licenses, certificates,
permission or exemptions which may be required for legal operation of the property including any
insurance required.
Article 7. Fuel
The Hirer shall be responsible for providing fuel and oil as necessary for transportation and
operation of the property on Hirer’s site, except for the fuel for transportation of carrier trucks of
drilling rigs which shall be taken care by the Owner.
A-21
Article 8. Property Handing Over, Exemptions
1. When the Hirer receives the property from the Owner, the Owner shall issue an equipment
checklist to the Hirer, and the Hirer shall sign on it upon completion of inspection with the
Owner as specified in Article 9.
2. The Owner shall hand over the property to the Hirer on the date of rental commencement.
3. As a general rule, the handing over shall be carried out at the office of the Owner.
4. If the handing over is carried out in a place other than stated in the previous Article, the Hirer
shall bear any of the resultant costs.
5. Responsibility for accidents related to carrying, transporting, and loading and unloading of the
property shall rest with the Hirer when the Hirer conducts the work and when the Hirer requests
any other party other than the Owner to conduct the work, and with the Owner when the Owner
conducts the work.
6. The Owner shall not be liable for delay or failure of property handing over in the result of an
event such as a natural disaster and man-made events, including electricity restriction, transport
accidents, traffic restriction, conflict with employees of the Hirer or third parties, or interference
of third parties, and any other events not accountable to the Owner’s fault.
Article 9. Property Inspection
1. The Hirer shall inspect the specifications, capacity, functions and quantity of the property on the
Owner’s yard for any defects or deviations against the descriptions in the equipment checklist
issued by the Owner immediately after the receipt of the property.
2. The Hirer shall immediately notify the Owner of any nonconformity, incompleteness,
insufficiency or defects. When notified by the Hirer, it is the responsibility of the Owner to repair
or replace the property.
Article 10. Warranty
1. The Owner guarantees the condition of the property at the point of handing over. The Owner is
not liable for the compatibility of the property with the purpose of the Hirer. When there is no
notification regarding defects of the property immediately after the handing over, it is regarded
that the property was handed over in good condition.
2. When the Owner is liable for damages regarding hired property in incidents of the Owner’s fault,
the maximum amount is the amount of the rental fee charged for the Individual Contract, and
also limited to the amount already paid by the Hirer.
3. The Owner shall not be liable for indirect, special, or incidental losses (such as construction
delay, idling, profit that would have been generated, profit loss, opportunity loss, etc.) inflicted to
the Hirer or third party caused by the fault of the property.
Article 11. Maintenance, Management and Monthly Inspection of the Property
1. The Hirer shall manage the property in accordance with the property’s appropriate use and
capacity, manage its safekeeping, and maintain the condition of the property for the period of the
reception of the property until the completion of the property return.
2. The Hirer must consult the maintenance manual for hirer with daily service check sheet prior to
use, carry out a start-up inspection, and conduct necessary maintenance work prior to
commencing operation.
3. Preventive maintenance and safekeeping costs of the property shall be borne by the Hirer.
4. Receiving advice from the technical instructor dispatched from the Owner, the Hirer shall be
responsible for conducting daily inspection and self-check for the properties that require them.
5. If the instalment, storage, or use of the property incurs damages to a third party, the Hirer shall
be responsible for solving the conflict, and the Owner shall not be liable.
Article 12. Examination of the Property
The Owner, with advanced notice to the Hirer, has the right to inspect the hired property’s
conditions of use and safekeeping at the site of its operation. During such events, the Hirer shall be
cooperative.
A-22
Manual on Hiring of Drilling Equipment
Article 13. Prohibited Matter
1. The Hirer shall not engage in any act which infringes on the right of ownership of the Owner,
including taking out a mortgage on the property, or transferring it to a third party.
2. The Hirer shall not allow operation and handling of the property by anyone but qualified
persons.
3. The Hirer, without written approval of the Owner, shall not conduct any of the following actions.
(1) Attachment of new equipment, parts, or accessories to the property, or removal of already
attached items.
(2) Modification of the property, or modification of its functions and capacity.
(3) Use of the property for purposes other than what it is intended for.
(4) Transportation of the property to any other place from where the Hirer indicated in the order
sheet.
(5) Transfer of the leasing rights under an Individual Contract, or sub-lease of the property to a
third party.
(6) Establishment of the right of pledge, mortgage, or any other rights on the property.
(7) Deletion or removal of any identifying marks or displays of ownership.
Article 14. Duty to Give Notice
1. The Hirer and Owner shall contact the other party immediately by the quickest practical method,
as well as notifying the party in writing, when any of the following occur.
(1) When theft, destruction, or damage was occurs to a hired property
(2) When the Owner or Hirer’s address is changed
(3) When the Owner or Hirer’s representative is changed
(4) When there is a major change in business operation
(5) When compulsory execution or any other legal and factual infringement occurred to the hired
property by a third party
Article 15. Measures to be Taken upon Completion of Individual Contract and Return of the
Property
1. Upon completion of the Individual Contract, the Hirer shall immediately return the property to
the site stated in the contract. The Owner shall check conditions of the property upon its
reception and record it in the equipment checklist which copy shall be provided to the Hirer.
2. The cost of transport and other related costs for transfer of the property shall be borne by the
Hirer, except for fuel for the carrier trucks of drilling rigs which shall be taken care by the
Owner.
3. The return of the property shall be done in the presence of the Hirer and the Owner. However, if
the Hirer is unable to be present, the Hirer has no right to object the inspection of the Owner.
4. The property shall be returned in the same condition as when it was hired. If there is any damage,
loss, missing parts, etc., the Hirer shall be responsible for restoring the property to the original
state, or the Hirer shall pay the cost of restoration (repair cost, cleaning cost, etc.) to the Owner.
Article 16. Property Compensation
1. The Hirer shall be responsible for the obligations stated in the agreement for damages,
destruction or theft of the property, for any circumstance including natural disaster.
2. If the Owner provides repair work for the damage of the property, the Hirer shall pay the
equivalent cost amount to the Owner.
3. The Hirer shall pay the Owner the cost of replacement of the property if the property right of the
Owner is not deemed to be recovered for property which was destroyed, stolen, etc., or the
damage of the property at the point of the return is beyond repair.
4. The Hirer shall provide compensation for the business suspension damage, if the repair or
replacement of the property requires time.
Article 17. Measures and Compensation for Damages in Cases of Non-Return of the Property
1. The Hirer shall bear full responsibility to compensate for damages incurred to the Owner by
A-23
non-return of the property.
2. The Owner shall take necessary legal measures when the Hirer does not return the property
despite the completion of the Individual Contract or contract cancellation in accordance with
Article 19.
Article 18. Insurance
1. The Owner shall obtain compulsory automobile liability insurance and automobile insurance
(personal reparations, property damage liability, and passenger reparations) for all vehicles with
number plates, and liability insurance for any other property.
2. The insurance required by the previous clause does not cover damages caused by natural disaster,
negligence or deliberate misuse by the Hirer, or cases stated in the exemption clause of the
insurance contract.
3. The Hirer shall take legal measures and notify the Owner immediately when an insurable
contingency has occurred, regardless of its size, and submit documents to the Owner as
instructed.
Article 19. Contract Cancellation
1. The Owner retains the right to cancel the contract without notification, if any of the following is
applicable.
(1) When the Hirer violated the articles of this contract or Individual Contract.
(2) When the Hirer delayed fulfilling its financial obligations to the Owner, including the rental fee,
repair fee and other fees.
(3) When the check or bill issued or certified was not honoured, or when the Hirer became
insolvent or fell under the condition of suspension of payment.
(4) Disposition for failure to pay taxes and public dues, temporary restraining order for execution
of other obligations, writ of attachment, auction, or other disposition of the government authority
was received, or bankruptcy, civil rehabilitation, corporate reorganisation was declared, or when
the business operation is in de facto non-operational state, for instance, when it started
liquidation.
(5) When the Hirer does not carry out proper maintenance of the property, or when it violated the
use of the property determined by the law and other regulations.
(6) When the Hirer dissolved, deceased, or became a Person with Limited Capacity, or its address
or location became unlocatable.
(7) When an incident severely degrades the financial status of the Hirer, or such an incident is
deemed objectively imminent.
(8) When the Hirer conducts an iniquitous deed (illegal or threatening to the public order) regarding
the use of the hiring service.
2. When the Owner cancels the contract in accordance with the previous clause, the Hirer shall
return the property to the Owner without delay and shall pay the Owner the rental fee up for until
the date of property return and all the related fees.
3. If any of the items described in Clause 1 apply to the Hirer, the Hirer forfeits its right to the
hiring period, and shall pay the outstanding balance to the Owner.
Article 20. Measures for Contract Cancellation
1. The Hirer shall return the property to the determined location without delay upon a request of
property return from the Owner in accordance to the previous Article.
2. When the Hirer fails to return the property immediately, the Owner shall enter the operation site
of the property to retrieve it. If there are damages, the Hirer shall bear the cost.
3. The Hirer shall bear all costs of transport for the property return and transfer and any other
related costs, except for fuel for the carrier trucks of drilling rigs which shall be taken care by the
Owner.
4. The Hirer shall bear the cost for repair, if the property is damaged or there are discrepancies from
the original condition, at the point of property return.
5. The return of the property shall be done under the presence of the Hirer and the Owner, when the
Hirer is absent from the handing over, it is regarded that the Hirer has no objection to the result
A-24
Manual on Hiring of Drilling Equipment
of the inspection by the Owner.
6. The Hirer shall fulfil obligations stated in the contract until the property return is complete.
7. The Owner shall not be liable for damages incurred to the Hirer from cancellation of the
contract.
Article 21. Early Termination
1. Early termination during the Individual Contract period is not allowed. However, if the Hirer
requests an exemption from the Owner for a special case, and if the Owner acknowledges its
legitimacy, early termination is permissible.
2. When early termination is approved in accordance to the previous clause, the Hirer immediately
carries out the procedures in accordance with Article 14.
Article 22. Compensation for Contract Cancellation
When the property was returned in accordance with Article 19, the Hirer shall pay a predetermined
amount of compensation for damages. If it is not predetermined, it shall be determined by mutual
consent between the Hirer and the Owner.
Article 23. Joint and Several Surety
The Hirer shall appoint a joint and several surety if the Owner requests it. The joint and several
surety shall jointly and severally bear contract obligations with the Hirer.
Article 24. Exclusive Agreement Jurisdiction
If conflicts arise between the Hirer and the Owner regarding the rental contract, a court that has
jurisdiction over the address of the headquarters, or a branch of the Owner, shall be the venue for
the first trial.
Article 25. Supplementary Conditions
The Hirer and the Owner shall solve any situation that is not described in the agreement or
Individual Contract, in good faith.
A-25
Annex 10 Form for Report on Technical Instruction
Report on Technical Instruction to Private Drilling Companies
Date of Submission
Name of Technical
Instructor
Name of Client
Hiring Period of Drilling Rig
Location of Drilling Site
No. of Boreholes Drilled
Total
Production Well
Dry
with the Hired Rig
Average Depth of
Boreholes Drillied
m
m
m
Diameter of Boreholes
Drilled
inch
inch
inch
Observations on Skills of
Drilling Team
Observations on
Management of Work
Schedule
Technical Advice/
Guidance Given to the
Client on Site
Difficulties Encountered
during Technical
Instruction
The on-site checklist of drilling technical level should be attached to the report for submission.
A-26
Manual on Hiring of Drilling Equipment
Annex 11 Checklist of Equipment
Checklist of Equipment
No. of Order Form
Business Entity
Name
Name and No. of Hired
Item
Handing Over of Equipment
Date
Defects Found on
Equipment
before
Hiring
Name of Hirer
Signature
Name of Officer in
Charge
Signature
During Hiring Period
Fault on Drilling Rig
Reported during Hiring
Period
Measures Taken to
Remedy the Fault on
the Rig
Return of Equipment
Date
Defects Found on
Equipment after Hiring
Name of Hirer
Signature
Name of Officer in
Charge
Signature
Pictures of the equipment should be taken before and after hiring and attached to this checklist.
A-27















Content      ..     4      5      6      7     ..
